Production line planning

Production line planning involves creating a detailed strategy for the manufacturing process, including determining resources, scheduling tasks, and establishing quality control measures. The goal is to ensure efficient, cost-effective, and high-quality production.

  1. Production queue filters:
    a. ID

    b. Material

    c. Production version

    d. Quantity

    e. Outbound delivery number

    f. Goods issue time

    g. Required start time

    h. Required finish time

    i. Created

    j. Handling unit template

    k. Scheduled finish time

    l. Estimated times

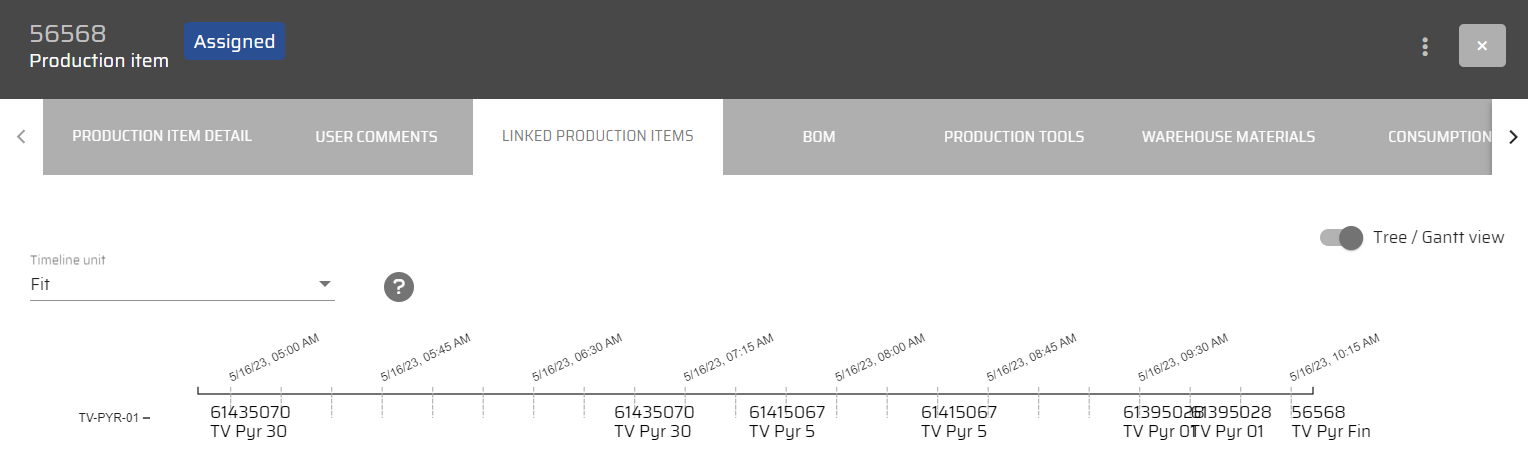

  2. The dot shows the items from the bill of materials that make up the product, how many pieces do I need for production? The color indicates the current status of the pieces I have in stock:

  3. Red = there are not enough pieces in stock and neither in planning

  4. Blue = zaplánovaná výroba ale není na skladě - stihne se (materiál BOMu u kterého se to ukazuje)

  5. Green = there are enough pieces in stock immediately

  6. Material change → line reconfiguration (set in the parameterization)

  7. Breaks

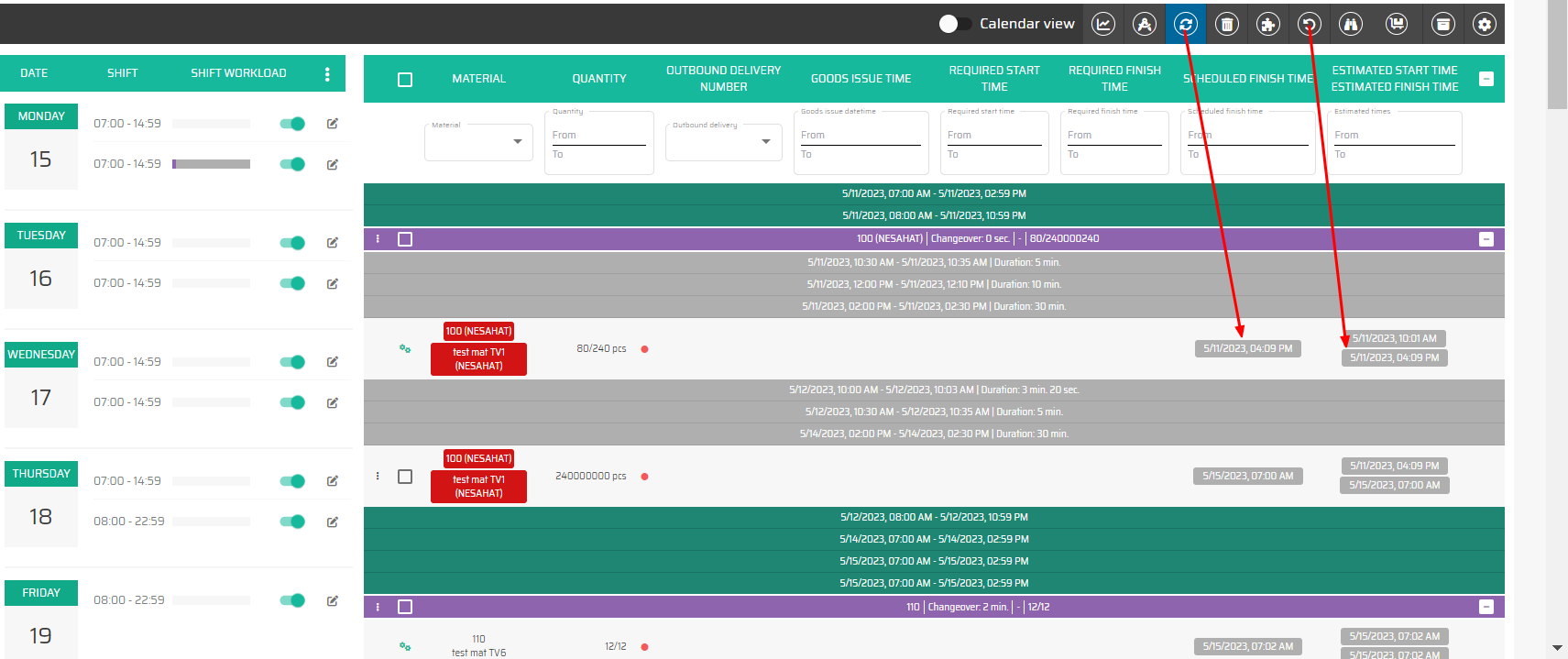

  8. Red Scheduled finish time → Line delays

List of individual times used in line planning and where this data is taken from:

GOOD ISSUE TIME

A) If there is a direct link between WO and CO item, the Planned Completion Time listed in the CO item (or the entire CO if no specific time was entered for the CO item) is taken
B) If there is no direct link between WO and CO item (WO was created in the distribution table without a link to CO), this field is blank

REQUIRED START TIME

A) If entered during assignment to the production line, it is marked with a snowflake and serves for a fixed freezing of the start of the WO production time
B) If the Required Completion Time was entered, the Required Start Time is automatically calculated from the production time
C) If the Required Start Time and Completion Time were not manually entered, they are calculated based on the schedule and related WOs so that the production times of the linked items are sequentia

REQUIRED FINSIH TIME

A) If entered during assignment to the production line, it is marked with a snowflake and serves for a fixed freezing of the completion of the WO production time
B) If the Required Start Time was entered, the Required Completion Time is automatically calculated from the production time
C) If neither Required Start Time nor Required Completion Time were manually entered, they are calculated based on the production order and related WOs to ensure that the production times of connected items are properly aligned - see the previous screenshot

SCHEDULED FINISH TIME

A) This is how the production plan was created and the line delay is calculated against it
B) If I schedule a WO on a completely empty line, where there was no queue, the first item in the production queue will have identical Planned Completion Time and Expected Completion Time, based on the start of the nearest shift. Once there is a time shift between the Planned Completion Time and the Expected Completion Time (expected delay), it will be highlighted in red to emphasize the delay compared to the plan. Other items in the production plan are calculated based on the first item in the list.
C) Other items in the production plan are calculated based on the first item in the list

ESTIMATED START TIME

A) It is always calculated based on the first item in the production queue.
B) This statement describes that the most accurate information is reflected by the system when another item is assigned to the production line. In this case, a declaration is made, sent to Redbox, or the estimated completion time is reset. The system then sets the start time to the nearest shift start time (if done between shifts) or the current system time (if done during production hours).

ESTIMATED FINISH TIME

A) It is always calculated based on the first item in the production queue.
B) It is calculated based on the Estimated Start Time, which is determined by the production times of the material and the quantity of the WO being produced, and in the future, it may also take into account the operator's skill level.

Action buttons affecting times in the production plan:

The gray button "Reset estimated times" sets the Estimated Start Time of the first item in the plan to the current time.

Calculated based on the Estimated Start Time according to the production times of the material and the quantity produced for the Work Order (and in the future, based on operator skill level).

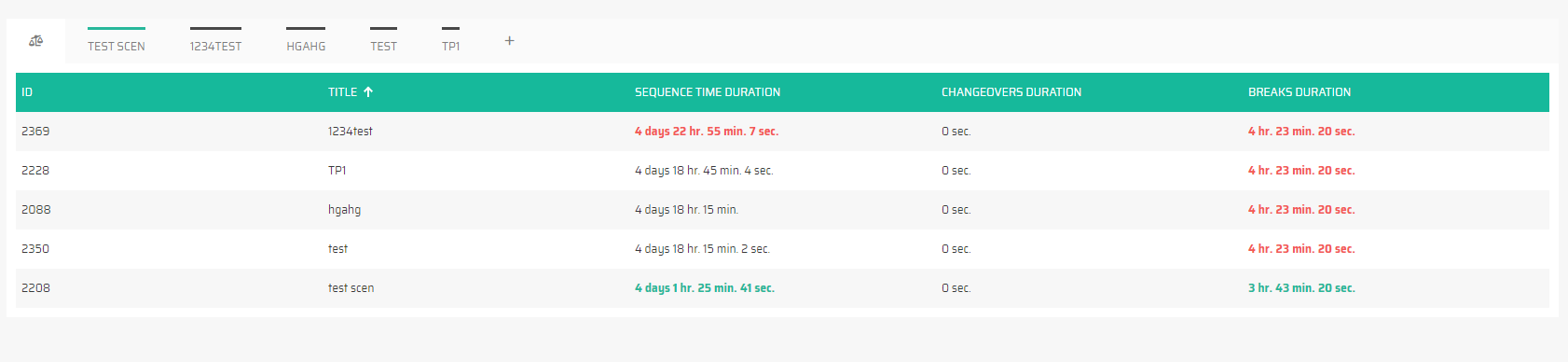

Scenarios
We have the ability to generate different options or possibilities and present an overview of each. Based on this, you can evaluate and determine which scenario is the most beneficial for you.

The green scenario is active.

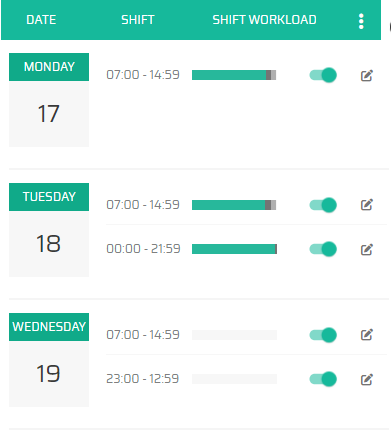

List of currently generated shifts

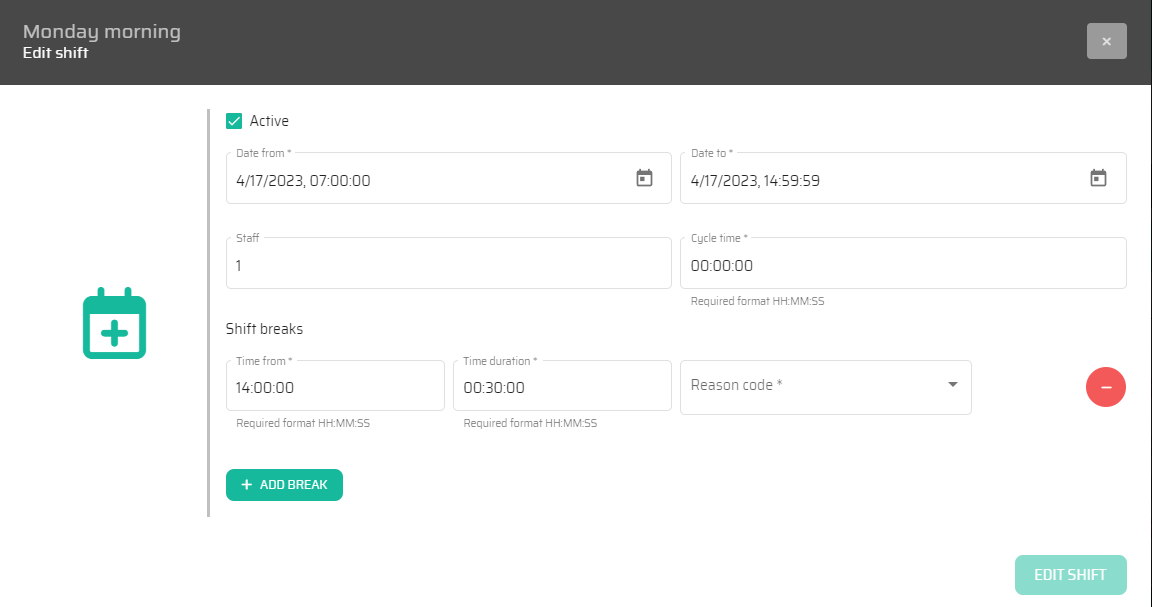

Here you can see the scheduled shifts for the following days:

You can simply turn the shift off with :Shutdown:

You can hide the shifts tab with :SHIFT:

Or you can change the following information by clicking on :Change:

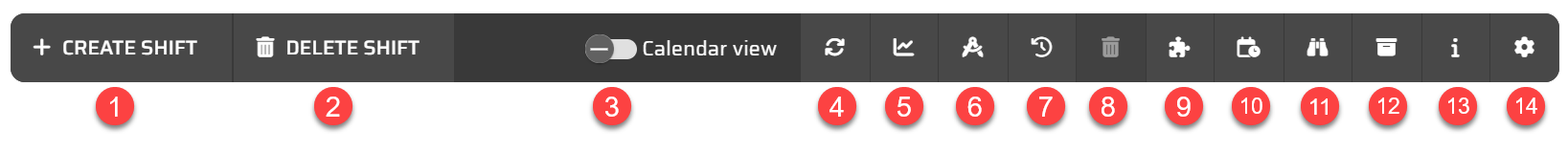

In the main bar, we have the following options:

Action

Description

Create Shift

Manually create production Shift

Delete Shift

Delete production shifts from selected date

Calendar / Sequence view toggle

Switch view between sequence liset and calendar

Update data

Refresh data in planning

Show Queue Statistics

Display queue KPIs

Set Planner

Open Artificial Planner options

Reset Time Difference

Set for all items in queue their Scheduled start and finish times to the same values as their Estimated start and finish times - resets the Delay/Advance of the line.

Also regenerate production shifts based on line settings.

Delete Scenario

Delete this queue scenario (only non-active)

Batch Building

Open dialog with batch building of this line

Recalculate Estimated Times

Recalculate Estimated star and finish times

Show Production Line log

Dialog with detailed log of changes in queue

View Line Redbox

Redirects to Redbox list pre-filtered by this production line.

Show hint

Shows color legend for calendar planning

Customize Table

Open layout settings

JavaScript errors detected

Please note, these errors can depend on your browser setup.

If this problem persists, please contact our support.
